CALIFORNIA ENERGY CODE COMPLIANCE
California Energy Code Compliance provides professional Title 24 energy code compliance services for residential and nonresidential projects throughout California. Services include energy modeling and design documentation, CF1R–CF3R compliance support, and ECC field verification and diagnostic testing required for permit approval and final inspection. We support both legacy HERS-based projects and current ECC requirements, ensuring accurate compliance for projects permitted before and after January 1, 2026.
Our work supports architects, designers, contractors, and property owners by providing clear, code-compliant documentation and field verification throughout the construction process. Whether supporting new construction, additions, or alterations, we coordinate energy compliance requirements with project timelines to reduce delays, revisions, and inspection issues. Experience across multiple jurisdictions ensures consistent application of Title 24 requirements from design through final verification.
TITLE 24 RESIDENTIAL and NONRESIDENTIAL ENERGY CODE COMPLIANCE
ECC/HERS RATING FIELD VERIFICATION AND DIAGNOSTIC TESTING Energy Modeling & Design Documents CF1R–CF2R-CF3R
CALIFORNIA ENERGY CODE COMPLIANCE/ECC & HERS RATER SERVICES
PROVIDING ECC HERS AND TITLE 24 SERVICES
California Energy Code Compliance delivers certified ECC Rater and HERS Rating Services for homeowners and contractors is Southern California
California Energy Code Compliance has completed ECC training and will be officially recognized as an ECC Certified Rater when the ECC Program becomes effective on January 1, 2026
KEY CHANGES FOR HOMEOWNERS
CERTIFIED ECC-RATERS WILL BE REQUIRED ON PROJECTS STARTING AFTER 1/1.2026
Projects started before 1/1/2026 will remain HERS Rater verified
Projects that require ECC field verification/diagnostic testing and registered compliance documentation are submitted through the CEC-approved registry (CHEERS for the 2025 cycle), subject to the CEC-defined scope/exclusions.
CHEERS IS THE ONLY APPROVED ECC-PROVIDER AND REGISTRY AT THIS TIME*
Compliance Verification
All projects after starting after January 1, 2026 requiring field verification must work with CHEERS-approved ECC Raters and rigorously monitored by CHEERS and failed projects will require corrections
IF A PROJECT FAILS, THE ECC RATER IS ASSIGNED TO THAT PROJECT AND CANNOT BE REMOVED.
The registry collects homeowner and authorized agent contact info to improve accountability and allow follow-up for quality assurance. Contractors and designers may also be asked to provide contact information to support traceability. HOMEOWNER CONTACT INFORMATION MUST BE PROVIDED AND REGISTERED PRIOR TO ECC CERTIFICATION OF A PROJECT.
INTRODUCTION
Starting January 1, 2026, California’s Title 24 residential energy code compliance is transitioning from the Home Energy Rating System (HERS) to the Energy Code Compliance (ECC) Program. This change affects how energy efficiency measures are verified and documented for new construction, additions, and renovations in single-family and multifamily homes
California Energy Code Compliance has completed ECC‑Provider training and certification through CHEERS and will be officially recognized as ECC‑Certified Raters when the ECC Program becomes effective on January 1, 2026.
OWNER CONTACT INFORMATION
The registry collects homeowner and authorized agent contact info to improve accountability and allow follow-up for quality assurance. Contractors and designers may also be asked to provide contact information to support traceability.
CONTRACTORS
ECC Certified Raters
ECC‑Certified Raters ensures:
• Verified, accurate energy code compliance
• Reduced risk of inspection failures or rework
• Transparent documentation that satisfies Title 24 requirements
This transition ensures that energy code compliance is enforceable, consistent, and traceable, protecting homeowners and improving the quality of California’s building stock.
*Golden State Registry (GSR) is a California Energy Commission–certified HERS Provider for the 2022 Energy Code. GSR has not yet been approved as an ECC‑Provider for the 2025 Energy Code cycle.
RESIDENTIAL
-
Are you are considering a new construction project?
We can help! Hiring an ECC/HERS Rater early in the project will help each stage come together.
Do you need a contractor?
Do you need an energy consultant?
Have you already started a project?
Make an appointment for a free phone consultation. We can evaluate your CF1R and identify any potential issues, and rectify them before they cause delays. Set up a free phone consultation.
-
It is important to hire an ECC/HERS Rater early to address any potential issues that may have been over-looked on your compliance certificates. Call for a free phone consultation
-
Diagnostic Testing and Field Verification Required By the California Energy Commission-tests vary based on location and equipment installed. Contact us for details on your specific project.
-
Quality Insulation Inspection.
Consists of three separate inspections
Airseal-must me completed at rough-in before insulation is installed
Insulation-during or immediately after insulation install
Final airseal-done during drywall
-
We can pull your permit, complete ECC/HER verification, schedule final inspection, meet the inspector and facilitate any remediation necessary to close out your permit hassle-free.

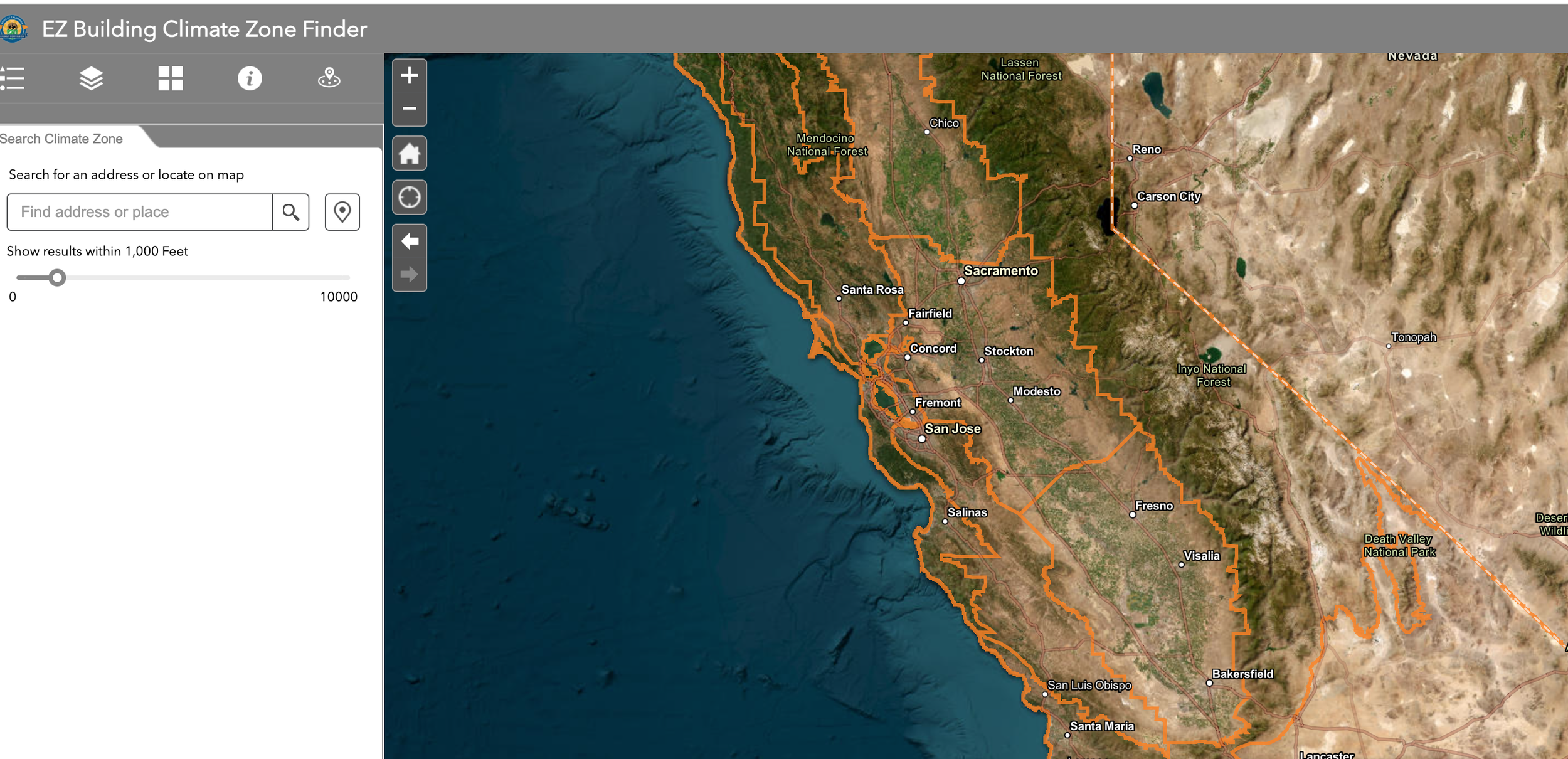

Interactive CF1R — California Title 24 HERS & ECC Compliance Explained
Duct Leakage Verification
What this is
Duct leakage testing confirms that the heating and cooling duct system is properly sealed and not losing conditioned air into unconditioned spaces.
Why it’s required
Leaky ducts reduce system efficiency, increase energy use, and can prevent a project from meeting its modeled performance targets.
What is tested
The duct system is pressurized and measured to determine total air leakage relative to the system size.
What to plan for
All ducts, plenums, and connections should be fully installed and sealed before testing. Common issues include unsealed boots, leaky plenums, and reliance on building cavities as ducts.
Quality Insulation Inspection (QII)
Quality Insulation Installation (QII) verification confirms that insulation is installed correctly so it performs as intended under the Energy Code. Proper installation quality is as important as the insulation R-value itself.
QII applies when specified on the CF1R and focuses on installation sequencing and workmanship. The initial air sealing inspection must occur before insulation is installed. This inspection verifies that all required air sealing measures are completed while framing and penetrations are still accessible.
The insulation inspection must occur after insulation is installed but before drywall. Insulation must be in full contact with the conditioned surface, installed without gaps or compression, and supported to maintain continuous coverage. This inspection must also occur before the AHJ insulation or drywall inspection, as insulation must remain fully visible.
Once drywall is installed, QII verification cannot be performed and no QII certificate can be issued. If drywall is installed prior to QII inspections, the project will fail compliance and corrective action may require removal of finished materials.
To avoid delays and costly rework, QII inspections must be scheduled early and coordinated closely with framing, insulation, and drywall contractors.
CF1R Compliance Overview
This interactive CF1R provides a clear, field-accurate explanation of California Title 24 energy compliance requirements. Each HERS and ECC feature shown below reflects how the measure appears on an actual CF1R (Certificate of Compliance) and can be expanded to understand when it is required, what is verified in the field, and how pass/fail determinations are made. This page is intended for owner-builders, HVAC contractors, designers, energy consultants, and plan reviewers who need a practical, code-correct reference to CF1R requirements without simplifying or misrepresenting the California Energy Code.
Airflow Verification
Airflow verification confirms that the heating and cooling system is delivering sufficient airflow to meet Title 24 field verification requirements. The purpose of the test is to verify minimum system airflow, not to optimize system performance.
For compliance, the measured airflow must meet or exceed the applicable threshold based on project type. Alterations generally require a minimum of 300 CFM per ton, while new construction typically requires a minimum of 350 CFM per ton.
Higher airflow values, such as 400 CFM per ton, are commonly used as design targets and are also used to establish allowable duct leakage percentages during duct leakage testing. These values are not the pass/fail airflow verification thresholds.
Airflow is measured at the system or register level after installation. To avoid test failures, ductwork must be complete, filters installed, and the air handler configured correctly prior to testing.
Refrierant Charge Verification
Refrigerant charge verification confirms that the air-conditioning or heat pump system contains the correct amount of refrigerant to operate as designed. Improper charge can significantly reduce efficiency, capacity, and equipment life.
The verification method depends on the system type. Variable-capacity, inverter-driven, ductless, and many side-discharge heat pump systems are verified using a refrigerant weigh-in procedure. For these systems, refrigerant must be installed by weight based on manufacturer specifications, with required adjustments for line set length and indoor coil configuration.
For weigh-in systems, verification must occur during installation, at the time of evacuation and charging, and in the presence of the installer. Once the system is fully charged, sealed, and operating, this verification cannot be recreated. If weigh-in verification is missed, the project may fail compliance and require corrective action determined by the registry or provider.
Traditional fixed-speed split systems are typically verified using field measurements while the system is operating. This process includes measuring return air dry-bulb and wet-bulb temperatures, refrigerant pressures, refrigerant line temperatures, and outdoor ambient conditions to confirm that the charge falls within allowable tolerance.
To avoid compliance failures, the correct verification method must be identified in advance, and refrigerant verification must be scheduled at the appropriate installation stage based on the system type.
Indoor Air Quality (IAQ) & Kitchen Ventilation
Indoor Air Quality (IAQ) verification confirms that required mechanical ventilation systems are installed and operating as designed to provide adequate fresh air and pollutant removal within the dwelling.
IAQ requirements are established by the CF1R and typically include whole-house ventilation and local exhaust, such as kitchen range hoods. Required airflow rates, equipment type, and control methods are defined during compliance modeling and must be met in the field.
Kitchen ventilation equipment must meet applicable airflow requirements and must be listed by AHAM or HVI when required by the compliance documentation. Many commonly installed range hoods do not meet these listing requirements, even when manufacturer airflow claims appear sufficient.
Verification may include confirming equipment listings, installation configuration, airflow performance, and sound ratings when applicable. To avoid compliance issues, ventilation equipment should be selected and reviewed early, installed per manufacturer instructions, and fully operational at the time of inspection.
| 01 | 02 | 03 | 04 | 05 | 06 |
|---|---|---|---|---|---|

| Control | Capacity (kWh) | Charging Efficiency | Rate (kW) | Discharging Efficiency | Rate (kW) |
| Basic | 5 | 0.95 | n/a | 0.95 | n/a |
- Battery System: 5 kWh (Self Utilization Credit taken)
- Indoor air quality, balanced fan
- IAQ Ventilation System: as low as 0.34375 W/CFM
- IAQ Ventilation System Heat Recovery: minimum 75 SRE and 77 ASRE
- Insulation above roof deck
- Window overhangs and/or fins
- Non-standard duct location (any location other than attic)
-
Quality Insulation Installation (QII) — Residential Appendix QII (RA3.5)Triggered when:QII is listed in the CF1R HERS Feature Summary as a required field verification for the project’s compliance run.Verification method:Field inspection per the QII protocol (quality of install: alignment, full contact, completeness, support, and treatment of obstructions/edges, as applicable to the assembly).Installer responsibility:Install insulation to the specified R-values and QII quality criteria: no gaps/voids, no compression, proper fit at corners/edges, proper support, and proper interface with the air barrier where required.Rater / ECC role:Inspect the installed insulation per the QII protocol and document results in the HERS Registry (CF2R/CF3R as applicable to the measure and project workflow).Pass / fail criteria:Pass requires meeting the QII protocol criteria for the inspected areas. If required areas do not meet the criteria, the QII measure cannot be signed off.Common failure causes:
- Voids/gaps at corners, transitions, or behind wiring/plumbing
- Insulation not in full contact with the air barrier (slumping/wind wash)
- Compression or misfit reducing effective R-value
- Missing/poorly installed baffles or blocking at eaves and roof edges
-
Indoor Air Quality (IAQ) Ventilation + Kitchen Exhaust — Residential Appendix RA3.7 (Mechanical Ventilation / IAQ Verification)Triggered when:The CF1R lists IAQ / ventilation as a required HERS-verified measure (typical when the compliance run credits verified ventilation fan efficacy, balanced ventilation, HRV/ERV performance, or otherwise requires field verification of the installed IAQ system). If “Kitchen Ventilation” is part of the project scope, the kitchen local exhaust must meet the prescriptive requirements and be verifiable in the field.Verification method:Field verification of the installed mechanical ventilation system and its settings (as applicable), including equipment identification (listed ratings), airflow/operation checks where required by the CF1R measures, and confirmation the system configuration matches the compliance documentation (whole-house ventilation type and controls; kitchen local exhaust type and ratings).Installer responsibility:Install the specified IAQ system and kitchen exhaust equipment per manufacturer instructions and project documents, including:
- Correct fan type (exhaust/supply/balanced; HRV/ERV if specified)
- Correct controls (continuous vs intermittent, timers/switching, labeled controls)
- Correct ducting (smooth/short where required, sealed connections, proper termination)
- Kitchen hood/fan listed ratings (HVI/AHAM listing as applicable) and sound rating where required
Rater / ECC role:Confirm the installed IAQ/ventilation system matches the CF1R requirement and any claimed compliance credit, verify required listed ratings and field settings, and complete registry documentation (CF2R/CF3R as applicable to the verified measure and workflow).Pass / fail criteria:Pass requires the installed ventilation/kitchen exhaust equipment and configuration to match the CF1R-listed requirement and meet the applicable protocol/required ratings and settings. If required components are missing, incorrectly configured, not listed as required, or do not meet the verified criteria used for compliance, the measure fails until corrected and re-verified.Common failure causes:- Wrong fan/hood model (missing required listing, airflow rating, or sound rating)
- Controls not set to the required mode (continuous/intermittent) or not accessible/labeled
- Long/restrictive or disconnected ducting; improper termination or backdraft damper issues
- Balancing/HRV/ERV installed but not commissioned to required settings (where required by the CF1R measure)
What this verification includes:Equipment verification (model/listing), configuration checks, any required airflow/operation confirmation tied to the CF1R-listed measure, and registry documentation support consistent with the CF1R requirement. -
Minimum Airflow — RA3.1.4.2 (Air Handler / System Airflow Verification)Triggered when:The CF1R lists “Minimum Airflow” in the HERS Feature Summary for the installed HVAC system (air handler airflow must be field verified as part of the compliance run).Verification method:Air handler / system airflow is measured per RA3.1.4.2 using an approved method and documented as the delivered airflow at the verified operating condition.Installer responsibility:Set up the system to deliver the required airflow (correct duct sizing, filter/grille selection, fan speed/airflow settings, appropriate static pressure conditions, and commissioned controls as applicable).Rater / ECC role:Measure and verify delivered airflow per RA3.1.4.2 and complete the required registry documentation (CF3R as applicable to the verified measure).Pass / fail criteria:Pass requires measured airflow to meet or exceed the minimum airflow requirement specified for the system in the compliance documentation / CF1R-listed requirement. If measured airflow is below the required minimum, the system fails until corrected and retested.Common failure causes:
- Restrictive filters or undersized / high-pressure-drop filter grilles
- Undersized return(s) or supply duct restrictions (kinks, crushed flex, excessive turns)
- Fan speed / airflow settings not configured for the installed system
- High external static pressure from poor duct design or restrictive registers
What this verification includes:Field airflow measurement, pass/fail documentation, and registry upload support consistent with the CF1R-listed requirement. -
Verified EER2 / EER — RA3.3 (System Efficiency Verification)Triggered when:The CF1R lists verified cooling efficiency (EER2 and/or EER) as a required HERS feature for the installed HVAC system. This applies when compliance credit or minimum efficiency verification is claimed based on certified equipment performance.Verification method:Verification is performed by confirming that the installed outdoor unit and indoor coil combination matches an AHRI-certified system with EER2 (and legacy EER, where applicable) values meeting or exceeding those specified on the CF1R. Field measurement of EER/EER2 is not performed.Installer responsibility:Install equipment that exactly matches the AHRI-listed combination used for compliance, including the specified condenser, indoor coil, and metering device. Equipment substitutions must be reflected in updated compliance documentation.Rater / ECC role:Verify installed equipment model numbers in the field, confirm the AHRI certification listing and associated EER2/EER values, and document compliance in the HERS Registry (CF2R/CF3R as applicable).Pass / fail criteria:Pass requires the installed system’s certified EER2 (and EER, where applicable) to meet or exceed the CF1R-specified efficiency. Systems that do not match the certified listing or fall below the required values fail verification.Common failure causes:
- Indoor coil or metering device does not match the AHRI-certified combination
- Equipment substitution without updating the CF1R/compliance model
- Incorrect model numbers recorded on CF2R/CF3R documentation
- Confusion between nominal ratings and certified EER2/EER values
What this verification includes:Field verification of installed equipment against AHRI certification data and registry documentation consistent with the CF1R-listed requirement. -
Verified EER2 / EER — RA3.3 (System Efficiency Verification)Triggered when:The CF1R lists verified cooling efficiency (EER2 and/or EER) as a required HERS feature for the installed HVAC system. This applies when compliance credit or minimum efficiency verification is claimed based on certified equipment performance.Verification method:Verification is performed by confirming that the installed outdoor unit and indoor coil combination matches an AHRI-certified system with EER2 (and legacy EER, where applicable) values meeting or exceeding those specified on the CF1R. Field measurement of EER/EER2 is not performed.Installer responsibility:Install equipment that exactly matches the AHRI-listed combination used for compliance, including the specified condenser, indoor coil, and metering device. Equipment substitutions must be reflected in updated compliance documentation.Rater / ECC role:Verify installed equipment model numbers in the field, confirm the AHRI certification listing and associated EER2/EER values, and document compliance in the HERS Registry (CF2R/CF3R as applicable).Pass / fail criteria:Pass requires the installed system’s certified EER2 (and EER, where applicable) to meet or exceed the CF1R-specified efficiency. Systems that do not match the certified listing or fall below the required values fail verification.Common failure causes:
- Indoor coil or metering device does not match the AHRI-certified combination
- Equipment substitution without updating the CF1R/compliance model
- Incorrect model numbers recorded on CF2R/CF3R documentation
- Confusion between nominal ratings and certified EER2/EER values
What this verification includes:Field verification of installed equipment against AHRI certification data and registry documentation consistent with the CF1R-listed requirement. -
Verified Refrigerant Charge — RA3.2 (Split Systems / Heat Pumps)Triggered when:The CF1R lists refrigerant charge verification as a required HERS measure for the installed HVAC system. Applies to newly installed or replaced split-system and ducted heat pump equipment subject to RA3.2.Verification method:Refrigerant charge is verified using the method required by the applicable protocol:
- RA3.2.2 — Standard charge verification using temperature, pressure, and airflow conditions, or
- RA3.2.3 — Weigh-in method for systems where standard verification is not allowed or not applicable (e.g., certain inverter-driven or variable-speed systems).
Installer responsibility:Install the system per manufacturer specifications, evacuate and charge the system correctly, provide required access ports, ensure proper airflow prior to charge verification, and support the required test or weigh-in procedure.Rater / ECC role:Observe and verify the refrigerant charge procedure per the applicable RA3.2 protocol, confirm test conditions, record measured values, and complete HERS Registry documentation (CF3R as applicable).Pass / fail criteria:Pass requires refrigerant charge to fall within the allowable tolerance defined by the applicable RA3.2 protocol. Systems outside the allowable range fail and must be corrected and re-verified.Common failure causes:- Airflow not set or verified prior to charge testing
- Improper test conditions (outdoor temperature, indoor load, or system staging)
- Incorrect lineset length or refrigerant adjustment not accounted for
- Weigh-in performed without proper scale accuracy or documentation
What this verification includes:Field verification of refrigerant charge, pass/fail determination, and registry upload consistent with the CF1R-listed requirement. -
Fan Efficacy — RA3.1.4.4 (Air Handler Fan Efficacy Verification)Triggered when:The CF1R lists fan efficacy (Watts/CFM) as a required HERS-verified feature. This typically applies when the compliance run requires verification that the installed air handler fan meets a maximum fan power limit.Verification method:Fan efficacy is verified by combining measured system airflow with measured fan electrical power at the verified operating condition, per RA3.1.4.4. The calculated Watts/CFM is compared to the applicable limit.Installer responsibility:Install and configure the air handler to meet fan efficacy requirements, including proper fan speed selection, ECM configuration (if applicable), and duct system design that avoids excessive external static pressure.Rater / ECC role:Measure delivered airflow and fan power per the RA3.1.4.4 protocol, calculate fan efficacy (Watts/CFM), determine pass/fail status, and complete registry documentation (CF3R as applicable).Pass / fail criteria:Pass requires calculated fan efficacy to be at or below the maximum Watts/CFM limit specified by the Energy Standards for the system type. Systems exceeding the limit fail until corrected and re-verified.Common failure causes:
- High external static pressure due to undersized or poorly designed ductwork
- Incorrect fan speed or airflow settings
- Restrictive filters, grilles, or registers
- Non-ECM fan or inefficient fan configuration not aligned with compliance assumptions
What this verification includes:Field measurement of airflow and fan power, calculation of Watts/CFM, pass/fail determination, and registry documentation consistent with the CF1R-listed requirement. -
Verified HSPF2 / HSPF — RA3.3 (Heating Seasonal Efficiency Verification)Triggered when:The CF1R lists verified heating efficiency (HSPF2 and/or legacy HSPF) as a required HERS feature for a heat pump system. This occurs when the compliance run requires confirmation of certified heating efficiency for the installed equipment.Verification method:Verification is performed by confirming the installed outdoor unit and indoor coil combination matches an AHRI-certified system with HSPF2 (and HSPF, where applicable) values meeting or exceeding those specified on the CF1R. HSPF/HSPF2 is not field-measured.Installer responsibility:Install equipment that exactly matches the AHRI-listed combination used for compliance, including condenser, indoor coil, and metering device. Any substitutions must be reflected in updated compliance documentation prior to verification.Rater / ECC role:Verify installed equipment model numbers in the field, confirm AHRI certification and associated HSPF2/HSPF values, and document verification in the HERS Registry (CF2R/CF3R as applicable).Pass / fail criteria:Pass requires the installed system’s certified HSPF2 (and HSPF, where applicable) to meet or exceed the CF1R-specified heating efficiency. Systems that do not match the certified listing or fall below the required values fail verification.Common failure causes:
- Indoor coil or metering device does not match the AHRI-certified combination
- Equipment substitution without updating the CF1R/compliance model
- Incorrect model numbers recorded on CF2R/CF3R documentation
- Confusion between certified HSPF2/HSPF values and nominal ratings
What this verification includes:Field confirmation of installed equipment identity, review of AHRI certification data, and registry documentation consistent with the CF1R-listed requirement. -
Verified HSPF2 / HSPF — RA3.3 (Heating Seasonal Efficiency Verification)Triggered when:The CF1R lists verified heating efficiency (HSPF2 and/or legacy HSPF) as a required HERS feature for a heat pump system. This occurs when the compliance run requires confirmation of certified heating efficiency for the installed equipment.Verification method:Verification is performed by confirming the installed outdoor unit and indoor coil combination matches an AHRI-certified system with HSPF2 (and HSPF, where applicable) values meeting or exceeding those specified on the CF1R. HSPF/HSPF2 is not field-measured.Installer responsibility:Install equipment that exactly matches the AHRI-listed combination used for compliance, including condenser, indoor coil, and metering device. Any substitutions must be reflected in updated compliance documentation prior to verification.Rater / ECC role:Verify installed equipment model numbers in the field, confirm AHRI certification and associated HSPF2/HSPF values, and document verification in the HERS Registry (CF2R/CF3R as applicable).Pass / fail criteria:Pass requires the installed system’s certified HSPF2 (and HSPF, where applicable) to meet or exceed the CF1R-specified heating efficiency. Systems that do not match the certified listing or fall below the required values fail verification.Common failure causes:
- Indoor coil or metering device does not match the AHRI-certified combination
- Equipment substitution without updating the CF1R/compliance model
- Incorrect model numbers recorded on CF2R/CF3R documentation
- Confusion between certified HSPF2/HSPF values and nominal ratings
What this verification includes:Field confirmation of installed equipment identity, review of AHRI certification data, and registry documentation consistent with the CF1R-listed requirement. -
Verified Heat Pump Rated Heating Capacity — RA3.3 (Equipment Capacity Verification)Triggered when:The CF1R lists verification of rated heating capacity for a heat pump system. This typically occurs when the compliance run relies on certified heating capacity (Btuh) for performance compliance or minimum system sizing confirmation.Verification method:Verification is performed by confirming the installed outdoor unit and indoor coil combination matches an AHRI-certified system with a rated heating capacity meeting or exceeding the value specified on the CF1R. Heating capacity is not field-measured.Installer responsibility:Install equipment that exactly matches the AHRI-listed combination used for compliance, including condenser, indoor coil, and metering device. Equipment substitutions must be reflected in updated compliance documentation.Rater / ECC role:Verify installed equipment model numbers in the field, confirm the AHRI certification and associated rated heating capacity, and document verification in the HERS Registry (CF2R/CF3R as applicable).Pass / fail criteria:Pass requires the installed system’s certified rated heating capacity to meet or exceed the CF1R-specified value. Systems that do not match the certified AHRI listing or fall below the required capacity fail verification.Common failure causes:
- Installed equipment does not match the AHRI-certified combination
- Capacity assumed from nominal sizing rather than certified AHRI data
- Equipment substitution without updating the CF1R/compliance model
- Incorrect model numbers recorded on CF2R/CF3R documentation
What this verification includes:Field confirmation of installed equipment identity, review of AHRI-certified heating capacity data, and registry documentation consistent with the CF1R-listed requirement. -
Duct Leakage Testing — RA3.1.4.3.1 (Duct Leakage: Fan Pressurization)Triggered when:The CF1R lists duct leakage testing in the HERS Feature Summary (typically when ducts are newly installed and/or when the compliance run requires leakage verification for the HVAC distribution system).Verification method:Fan pressurization test of the duct system to a specified test pressure (commonly 25 Pa) with measured total duct leakage (and/or leakage to outside, if applicable to the modeled measure) per RA3.1.4.3.1.Installer responsibility:Provide a testable duct system: seal joints/boots/plenums, install access as needed, ensure filters/grilles/closures are in place for the test configuration, and coordinate for test conditions (equipment and registers installed as required by the protocol).Rater / ECC role:Configure the system for the approved test setup, perform the leakage test per RA3.1.4.3.1, document results, and register the verification (CF3R as applicable) in the HERS Registry.Pass / fail criteria:Pass requires measured leakage at or below the applicable CF1R/standards threshold for the project’s measure and test type. If measured leakage exceeds the allowed limit, the system fails until corrected and retested.Common failure causes:
- Unsealed boots to drywall/subfloor; gaps at takeoffs
- Leaky plenums/air handler cabinet connections
- Disconnected or poorly clamped flex duct; torn flex
- Improper sealant (cloth-backed tape, dried/missing mastic)
- Building cavities used as ducts / panned returns
What this verification includes:Field test, pass/fail documentation, and registry upload support consistent with the CF1R-listed requirement. -
Ducts in Conditioned Space — RA3.1.4.1.3Triggered when:The CF1R claims ducts located entirely within conditioned space as a compliance measure. This is typically used for performance compliance credit and must be verified in the field.Verification method:Visual field inspection of the entire duct system combined with duct leakage testing, as required by RA3.1.4.1.3, to confirm no portion of the duct system is outside conditioned space.Installer responsibility:Install the complete duct system fully within the building’s thermal and air barrier. No duct sections, plenums, boots, or chases may be located in attics, crawlspaces, garages, or other unconditioned spaces.Rater / ECC role:Visually verify duct location in the field, confirm test configuration, perform or review required duct leakage testing, and document compliance in the HERS Registry (CF3R as applicable).Pass / fail criteria:Pass requires all ducts to be fully within conditioned space with no exceptions. If any portion of the duct system is outside conditioned space, the measure fails and cannot be signed off.Common failure causes:
- Duct boots or plenums extending into attic or crawlspace
- Use of unconditioned chases or dropped ceilings not within the air barrier
- Portions of the system routed through garages or exterior soffits
- Inadequate air barrier separation between ducts and unconditioned space
What this verification includes:Visual verification, confirmation of duct leakage test applicability, and registry documentation consistent with the CF1R-listed measure. -
Domestic Hot Water — Heat Pump Water Heater (HPWH) + NEEA requirement (project-specific)Triggered when:The CF1R / compliance documents specify a heat pump water heater (HPWH), and/or the project specifications require a NEEA-qualified HPWH (e.g., “NEEA Northern Climate Specification (NCS)” or equivalent owner/spec requirement).
Note: “NEEA” is not automatically a Title 24 requirement unless it is explicitly called out in the project’s compliance documentation or specs.Verification method:Document + field confirmation:- Confirm the installed HPWH manufacturer/model matches the compliance documents (and CF2R-PLB/CF3R-PLB if used on the project).
- If NEEA is specified: confirm the installed model is listed as meeting the NEEA requirement (typically via the NEEA-qualified products listing or manufacturer certification documentation).
- Field verify installation configuration relevant to performance (location/clearances, ducting if applicable, condensate management, and required controls/settings).
Installer responsibility:Install the HPWH per manufacturer instructions and applicable code requirements, including (as applicable):- Correct electrical circuit and disconnecting means
- Temperature & pressure relief (TPR) discharge piping
- Condensate drain or pump routing (and freeze protection where relevant)
- Seismic strapping (where required)
- Hot water pipe insulation and any recirculation controls per project specs
- Commissioning settings (mode selection, scheduling, demand response / CTA-2045 module if specified)
Rater / ECC role:If DHW verification is listed on the CF1R or required by the compliance workflow: confirm model/ratings documentation, confirm installed equipment identity in the field, and complete required registry documentation for the applicable plumbing/DHW forms used on the project.
If NEEA is specified: verify the NEEA qualification documentation aligns with the installed model.Pass / fail criteria:Pass requires the installed HPWH to match the specified model (and NEEA-qualified model if specified) and to be installed/configured per manufacturer requirements and the project specs used for compliance. If the installed unit is not the specified/qualified model, or installation conditions/settings are not consistent with the requirements, this item fails until corrected.Common failure causes:- Installed model differs from compliance docs/spec (or not NEEA-qualified when NEEA is specified)
- Improper condensate handling (no drain path, improper trap/routing, or freeze risk)
- Improper location/clearances or louvering/ducting that restricts airflow
- Wrong operating mode/settings compared to the intended compliance/spec assumptions
What this verification includes:Equipment identity confirmation, documentation review, and field confirmation of key installation/configuration items tied to the project’s compliance/spec requirements.
NON RES
ECC
ATT
Our Services
ECC Title 24 Diagnostic Testing & Field Verification
Diagnostic Testing and Field Verification Required By the California Energy Commission:
Variable Capacity Systems, ie mini-splits, most side discharge systems.
Traditional split systems and package units.
Ducts in Conditioned Space Verification-See Residential Appendices: RA3.1.4.1.3 for definition
Duct Leakage
Quality Insulation Installation Inspection. Seen as QII on your CF1R
Existing Conditions Inspection
Plumbing-All Lines Insulated
IAQ (Indoor Air Quality) Verification for Exhaust and Balanced Sytems
Verified EER/SEER
Kitchen Hood Verification
Building Leakage Diagnostic Testing
QII
Permit Expediting
Airflow
RESOURCES
OUR PARTNERS
Contact Us
Have questions? Fill out some info and we will be in touch shortly,or call/text/email 805.813.1204. We can’t wait to hear from you!
